Office Fit-Out Timeline in Singapore: A Realistic Week-by-Week Plan

A realistic office fit-out timeline for Singapore — design, landlord approvals, construction phases, and handover — so your team moves in on a date you can trust.

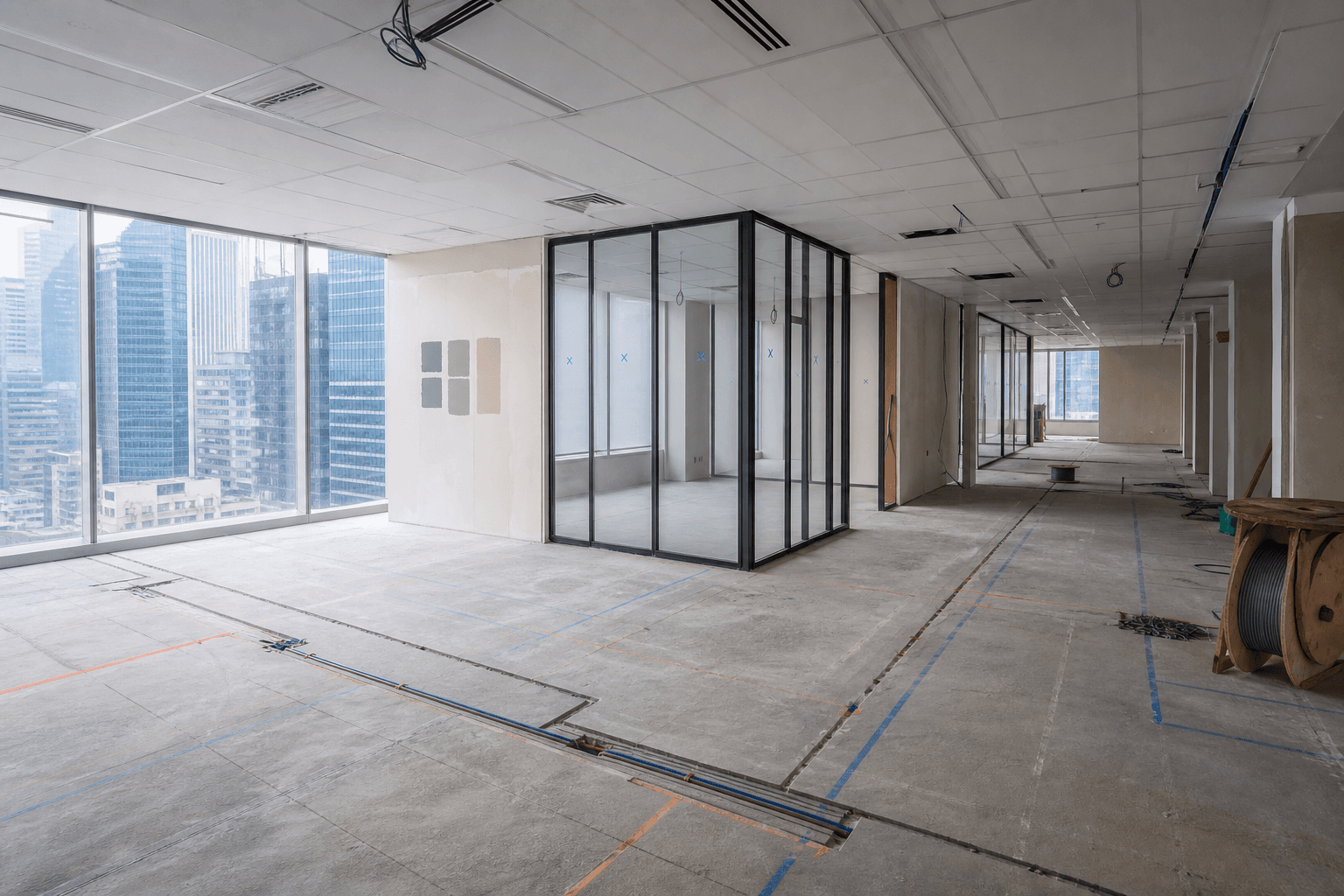

Singapore office renovation in progress with layout markings, glass framing, and electrical works underway

Ask ten contractors “how long does an office fit-out in Singapore take?” and you will hear “it depends.” That is true — but tenants still need a planning model they can put next to a lease commencement date.

Below is a realistic programme for a typical SME bare unit fit-out, plus the milestones that actually cause delay.

High-level timeline overview

  • Week 0–2: Brief, site survey, concept layout, preliminary budget
  • Week 2–5: Design lock, drawings, material specs, landlord submission
  • Week 4–7: Endorsements / building approvals (can overlap late design)
  • Week 6–12: On-site construction (size and complexity dependent)
  • Final week: Snagging, furniture install, IT coordination, cleaning, handover

Smaller units with light glass can sit at the short end. Larger floors, heavy acoustic suites, or restricted building hours stretch the on-site window.

Phase 1 — Brief and survey

Lock headcount, room list, brand constraints, and must-have dates. Survey the bare unit for levels, services, and constraints. This is also when you should sanity-check budget ranges before emotional attachments to finishes form.

Phase 2 — Design and landlord submission

Layout, partition types, electrical/data, aircon zoning, reflected ceiling, and finishes get drawn to a submission standard. Many Singapore buildings will not allow site start without clearance. Build this into the lease negotiation if your commencement date is tight.

Phase 3 — On-site construction sequence

  1. Site setup and protection
  2. Setting out and first-fix works
  3. Partitions / glass tracks and frames
  4. Electrical, data, and mechanical rough-in
  5. Ceiling / lighting interfaces
  6. Painting and finishes
  7. Glass doors, ironmongery, digital locks
  8. Furniture, CCTV, final fittings
  9. Testing, snagging, clean

Glass and mechanical long-lead items should be ordered before the site looks “ready for them.” Waiting until walls are painted is how programmes slip.

What usually delays Singapore office renovations

  • Late layout changes after submission
  • Unclear landlord comments looping for weeks
  • Underestimated electrical or aircon scope
  • Furniture lead times not aligned to handover
  • IT vendor arriving after locks and rooms are already wrong for cabling
  • Access / noise-work constraints in occupied towers

How to protect your move-in date

Appoint one accountable fit-out partner. Freeze the layout before drawings go for endorsement. Order glass and key furniture early. Schedule IT and movers against the same master programme — not a separate optimistic calendar.

If you are exiting another unit, overlay your reinstatement programme so old-floor strip-out and new-floor handover meet cleanly.

FAQ: office fit-out timeline Singapore

Can a small office be done in a month?

Sometimes, if approvals are ready, scope is simple, and the building allows productive hours. Treat “four weeks total including design and approvals” as risky unless the unit and landlord path are already clear.

When should furniture be ordered?

As soon as workstation counts and finishes are locked — often during late design / early approval, not after painting.

Who coordinates IT and AV?

Your fit-out contractor should leave containment, power, and room dimensions ready. Your IT vendor still owns active equipment — align both calendars early.
